Smart Locker Network Requirements: Power, Ethernet, Wi-Fi and Offline Operation

A practical guide for IT, facilities and security teams preparing a connected locker installation. Confirm the system architecture, site network, access method and continuity plan before procurement—because requirements depend on the configured controller, cloud platform and integrations.

For IT & network teamsSite-readiness checklistProject-specific guidance
Vpod smart locker installation in a workplace corridor, illustrating the physical site that must be surveyed before network and power approval
Start with the installed environment, then confirm the technical schedule for the selected configuration.
THE SHORT ANSWER

There is no single network specification for every smart locker.

Requirements depend on the configured locker controller, cloud platform, user-access method, integrations and the continuity behaviour the organisation needs. A permanent, centrally managed workplace system may have different dependencies from a temporary parcel point or a reader-led installation. The final design should be agreed for the selected hardware, software version, location and operating model.

Before ordering, ask the supplier for a project-specific technical schedule. It should identify the power supply and isolation, the communications path between locker components, the external network connection, required network destinations and ports, identity and integration dependencies, and what users can do if a dependency is unavailable. Do not accept a generic statement such as “Wi-Fi required” as a complete infrastructure design.

Planning principle Record what must work, where each dependency sits, who owns it, how it will be secured and how it will be tested at acceptance.

01 / SEPARATE THE LAYERS

“Wireless access” does not mean a wireless locker system.

Four different requirements are often collapsed into one conversation. Keep them separate in the specification so the site team can plan each one correctly.

01

Power

The electrical supply for the selected terminal, controller and other powered components, including isolation and the route to the equipment.

Electrical readiness
02

Door-control communication

The local connection between the control equipment and electronic locks or locker banks. The design may use internal wiring or another configured method.

Local system design
03

Network connectivity

The IP path used by the configured platform or connected systems for management, updates, events, integrations and support.

Site network approval
04

User authentication

The method a user presents at the locker, such as a badge, PIN, QR code or mobile credential. It is not itself the system’s network connection.

Identity & access policy

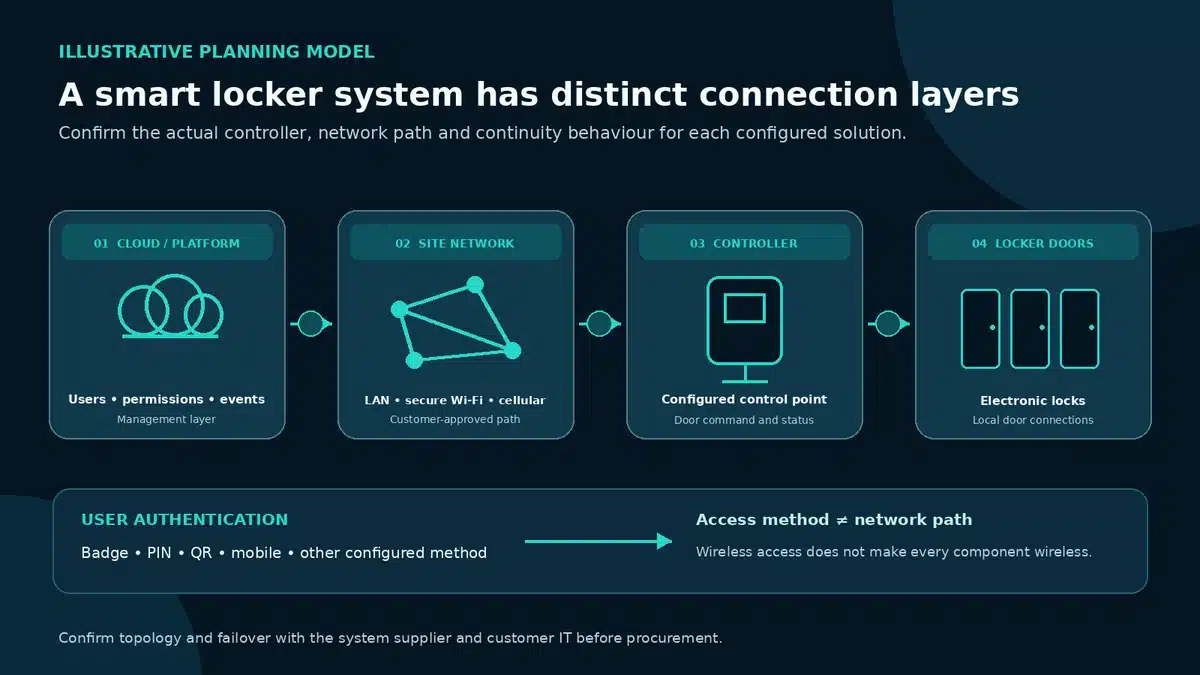

Illustrative smart locker architecture showing cloud platform, customer site network, locker controller and locker doors, with user authentication shown as a separate layer
Illustrative planning model only. Confirm the selected Vpod configuration, control topology and continuity behaviour with the project team.
Why this matters

A QR code or badge may be presented locally while the broader system still depends on a controller, site network or cloud service. Likewise, a locker can use a wired site connection while offering users a mobile access journey. Specify each layer rather than inferring one from another.

02 / OPERATIONAL DEPENDENCIES

When does a smart locker need connectivity?

Connectivity matters whenever the configured service must exchange information with a management platform or another system. It can support the following activities, although the exact design and timing vary by product configuration and workflow.

  • Synchronising users and permissionsApply new users, role changes, time windows and revoked access from the agreed identity or administration source.
  • Sending allocations and notificationsAssign a compartment, deliver a collection instruction or update the user when the workflow changes.
  • Recording access and door eventsReport a deposit, opening, collection, return, denied attempt or authorised override for operations and audit.
  • Updating occupancy and availabilityKeep the operating view aligned with the current state of a locker bank where the design supports live status.
  • Running reports and remote administrationLet authorised teams manage service settings, review activity and support users across one or many locations.
  • Connecting business systemsExchange the approved data needed by identity, workplace, access-control, service-management or parcel workflows.
  • Monitoring health and supportSurface faults or service status when monitoring is included and the relevant path is available.
03 / CONNECTION CHOICES

Ethernet, Wi-Fi, cellular or a hybrid design?

There is no universally best medium. Compare each option against site conditions, security policy, resilience expectations, construction constraints and who will operate the connection.

ConnectionAdvantagesLimitations to planOften considered for
EthernetStable, controlled and predictable when the route and switch configuration are approved.Requires cabling, an available switch port, a suitable route and agreement on addressing, VLAN and support ownership.Permanent enterprise installations and locations with managed structured cabling.
Secure Wi-FiCan make placement more flexible and reduce new data cabling in suitable locations.Coverage, roaming, interference, authentication method, certificate lifecycle and local wireless policy need validation.Offices and campuses with managed wireless infrastructure and an approved device onboarding process.
CellularCan provide a network path independent of the customer LAN and may help in temporary or difficult sites.Signal quality, antenna position, data plan, carrier service, SIM ownership and support dependency require decisions.Temporary, public or remote sites where customer LAN access is impractical and cellular use is approved.
HybridCan add flexibility or resilience where the design supports a secondary path.Introduces configuration, failover, monitoring, security and ownership decisions; a second connection is not automatic failover.Critical or multi-site programmes with a defined availability target and tested recovery approach.

Selection test: Which connection is approved, monitored and supportable at this location—and what is the expected behaviour when it fails?

04 / POWER & PHYSICAL INFRASTRUCTURE

Plan the cabinet, control point and service route together.

Network approval cannot compensate for an incomplete installation plan. The site survey should identify the final locker position and the routes for power, data and local cabinet connections before any enabling work is scheduled.

Confirm where the approved supply will be provided, who installs and isolates it, and how it will reach the terminal, controller and any other powered devices included in the design. Ask the supplier to provide the load and connection details for the selected equipment. The electrical contractor should work from that approved schedule and the site’s electrical standards rather than from assumptions about a generic locker system.

Cabinet-to-cabinet routes also need attention. The layout may require internal or inter-bank connections, access for commissioning, a clear path for future maintenance, and an agreed method for protecting cables from damage. Confirm whether the floor, walls, skirting, raised floor, fire stopping or furniture layout affects the route. Keep service clearances and user circulation in view while positioning the terminal and readers.

Agree whether backup power is required and what it is expected to preserve. A UPS may support selected components for a period, but it does not automatically preserve cloud access, mobile services or integrations. Document the intended behaviour and test it.

Facilities pain pointLate power or cable changes can delay installation, create visible surface routes or force an otherwise avoidable cabinet redesign. Close the physical survey before design freeze.
Vpod office locker installation photographed during site planning; survey work should confirm cabinet position, power and cable routes
Survey the installed location, not just the floor plan. Image: Vpod Smart Locker Installation Guide.
Read Vpod’s installation guide ↗
05 / SECURITY & NETWORK APPROVAL

Give IT and security enough detail to approve the design.

“It uses the internet” is not an approval-ready description. The customer’s IT, network and security teams need to understand what connects, why it connects and how the connection is governed.

01

Segment the deployment

Agree whether locker components belong on a dedicated device network, a facilities segment or another approved zone. Define the permitted communication between segments and who maintains the rules.

02

Document firewall flows

Request the current outbound and any required inbound connection details, including destination names, ports, protocols, purpose and initiation direction. Confirm whether services use fixed or changing addresses and how changes are communicated.

03

Own credentials and certificates

Record who provisions, stores, rotates and revokes network credentials, API secrets, certificates and service accounts. Define expiry, recovery and handover at project exit.

04

Protect data in transit

Confirm the encryption and authenticated connection approach for each external path and integration. Ask what information is exchanged and how secrets are protected; do not assume that a working connection is a secure one.

05

Log and monitor access

Identify which system records connection, authentication, administrator and locker events; who can review them; how alerts reach support; and which retention rules apply.

06

Control support and change

Define remote-support access, approval, session logging, permitted hours and emergency escalation. Include patching, software change, vulnerability reporting and maintenance windows in the operating agreement.

Security review question

Could the customer disable a route or credential safely, and would the service owner know what operational function would stop?

Review Vpod’s smart locker security guidance ↗
06 / INTEGRATIONS & API DEPENDENCIES

Trace the network path through the whole user journey.

An integration can add endpoints, data exchanges, identities and failure conditions beyond the locker platform itself. Identity providers, access control, workplace platforms, IT service-management systems and parcel platforms may each have separate environments and owners.

Document the source and destination of each exchange, the data required, the event that triggers it, its frequency, the authentication method, the expected response, timeout and retry behaviour, and the owner who investigates a failed transaction. Clarify whether integration traffic is initiated by the locker platform, an external service or both.

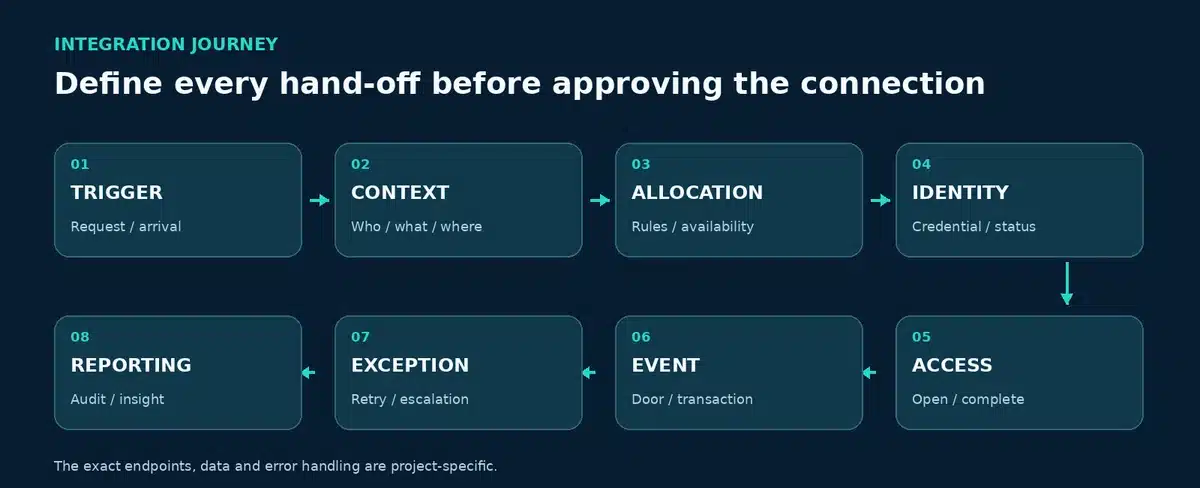

Eight-stage smart locker integration journey from trigger and context through allocation, identity, access, event, exception and reporting
Vpod integration planning journey: define the data and network dependency at each step, including exception handling.
TriggerContextAllocationIdentityAccessEventExceptionReporting
07 / CONTINUITY & OFFLINE OPERATION

Ask what still works when a connection is unavailable.

“Offline smart locker” can mean several different things: a user may keep using a locally cached credential, a controller may continue operating without its cloud path, an event may be stored locally until service returns, or the entire user journey may depend on connectivity. The answer is configuration-specific. Do not assume that a locker is offline-capable—or that offline access is included—without a documented response for the selected system.

For each failure, agree the expected user experience, operational workaround, record keeping and recovery test. Ask which functions require a live identity check or external transaction, what data is cached, for how long, and how administrators can identify the status. Clarify the boundary between loss of internet, loss of the site LAN or Wi-Fi, loss of an integration, platform unavailability, power loss and a local equipment fault; each can have a different impact.

CONTINUITY REVIEWCONFIGURATION-DEPENDENT
Existing users

Can a previously authorised user still access a compartment? Under which credential and time limits?

New assignments

Can a new parcel, asset issue or locker allocation be created while a dependency is down?

Event records

Are events queued locally, and how are timestamps, duplicates and reconciliation handled after recovery?

Integration actions

Which triggers, notifications or identity checks stop, retry or move to manual handling?

Administrator overrides

What authorised recovery options exist, and how is every override recorded and reviewed?

Service restoration

Who confirms data and occupancy are reconciled, the connection is healthy and users can resume?

08 / PRINTABLE SITE-SURVEY CHECKLIST

Take these decisions into the site survey.

Use the list as a readiness record. Mark each item only when the named owner has confirmed it for the selected configuration.

Download checklist CSV

To print from this page, use your browser’s print command. The article layout simplifies automatically on paper.

09 / DELIVERY OWNERSHIP

Make infrastructure responsibilities explicit.

Use the matrix as a starting point for project discovery—not as a universal allocation of contractual duties. Confirm the final lead, contributors, deliverables and acceptance authority for each deployment.

ResponsibilityCustomer ITFacilitiesVpodIntegration partner
Power readinessConsultedLead / confirm site worksProvide equipment scheduleConsulted if affected
Network approvalLead / approve controlsCoordinate access and routesProvide current technical requirementsProvide integration endpoints
Locker configurationConfirm identity/network constraintsConfirm operating workflowLead agreed locker setupConsulted where integrated
API configurationApprove identity and securityConfirm process ownerConfigure agreed locker interfaceLead its own platform configuration
Acceptance testingTest network/securityTest user and site operationTest locker journeysTest integrated data flow

The labels above are indicative. The statement of work, technical design and site-specific responsibility matrix must define the final accountabilities.

VPOD DEPLOYMENT EVIDENCE & VIDEO

Use real workflows to test your architecture.

Case studies help teams ask practical questions about central management, multi-site operation, identity, parcel handling and system hand-offs.

Vpod Mars IT asset locker case study for a connected multi-site workplace programme
ENTERPRISE / MULTI-SITE

Mars: plan the estate, not one cabinet

Vpod’s published case study describes 27 locker walls and 874 doors across 15 sites in nine countries. It is useful evidence for central oversight and rollout scale; the network schedule for a new deployment still needs project-level confirmation.

Explore the Mars case study ↗
Vpod and FacilityOS LogisticsOS parcel management integration workflow
PARCEL / INTEGRATION

FacilityOS + LogisticsOS: trace the hand-offs

The case study shows a connected flow from parcel receipt and recipient matching through locker allocation, notification and authenticated collection. Use it to map endpoints, data ownership and exception routes.

Explore the parcel integration ↗
Vpod smart locker wall at a Skyscanner workplace, part of a centrally managed three-office deployment
WORKPLACE / CENTRAL MANAGEMENT

Skyscanner: support several offices consistently

The workplace case study describes a centrally managed locker service across London, Edinburgh and Glasgow. Ask how remote administration, local site connectivity and support ownership will work in your own estate.

Explore the Skyscanner case study ↗
Fulcrum-branded Vpod parcel locker installation at Canary Wharf
ESTATE LOGISTICS / PARCELS

Wilson James + Fulcrum: connect the handover

The Canary Wharf case study joins consolidated deliveries, real-time tracking and secure locker collection in a connected estate logistics service. Use this type of workflow to identify the systems and teams on each side of an API.

Find Wilson James and Fulcrum in Vpod case studies ↗
READY FOR TECHNICAL DISCOVERY?

Bring IT, facilities, security and the workflow owner to the same conversation.

Share your site locations, user journey, preferred access method, network policies, integrations and continuity objectives. Vpod can help shape the project-specific technical discovery and installation plan.
